Time ProportionalityThis measurement technique is suitable for work packages where you are planning activities which cover the whole period of processing, such as consulting or administration.
You must maintain the start and finish dates for the WBS element or activity:
For the Planned POC: Basic dates
You maintain planned dates for WBS elements in date planning, the project planning board, or structure planning: Basic start and finish dates
The system schedules planned dates for activities: Basic start and finish dates
For the Actual POC: Actual dates
The actual dates in WBS elements: Actual start and finish dates
The actual dates in activities are as follows:
If no final confirmation has been made for the activity: Actual start and duration
If a final confirmation has been made for the activity: Actual start and finish dates
You can either enter the actual dates yourself manually, or have the system determine them using confirmations.
The system determines the duration using the:
Dates maintained
Factory calendar applying to the object
In progress version customizing, you stipulate which set of dates the system should use to determine the POC:

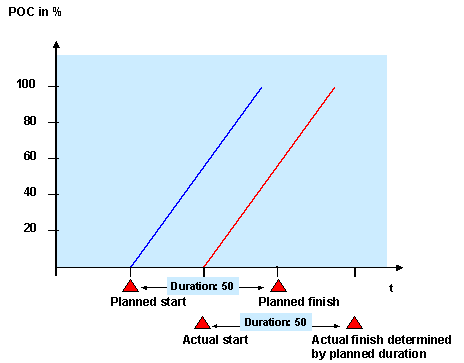

The system assumes linear progress of the project over time. It determines the POC in proportion to the total project duration. Until a final confirmation is entered for the activity, the system adopts the planned overall duration as the actual overall duration.
The system uses the factory calendar to determine the duration. This means that the POC calculation takes account of events such as plant shutdowns. As a result, the POC for a particular period may increase only by an insignificant amount, or not at all.
You have maintained the following dates for an activity:
Planning type |
Basic start - basic finish |
Date |
25. 01. 99 - 06.04. 99 |
This results in the following POC values:
Period |
1 |
2 |
3 |
4 |
Overall duration |
Workdays per factory calendar - plan |
5 |
20 |
23 |
2 |
50 days |
Planned POC |
10% |
50% |
96% |
